Community Recreation Center

Share Community Recreation Center on Facebook Share Community Recreation Center on Twitter Share Community Recreation Center on Linkedin Email Community Recreation Center link

Thank you to the Community Recreation Center funders: GJ residents and visitors via sales tax, the Department of Local Affairs, and St. Mary's.

2026:

The Community Recreation Center is expected to open to the public in late 2026. Memberships will go on sale June 8, 2026. Please visit the Community Recreation Center Website for more information about the facility.

2025:

The City of Grand Junction Parks and Recreation invited residents to help shape the identity of the new Community Recreation Center through an online survey and a community meeting. The survey gathered input on naming and visual style. On April 1, 2025, community members attended an interactive meeting at the Lincoln Park Barn, where they received project updates, shared feedback on branding elements, and explored ways to stay involved, including signing up for future construction tours. View a live recording of the presentation below.

A groundbreaking event for the new facility was held on Saturday, June 1, 2024, at Matchett Park.

City Council adopted the final plan in November, 2022. This became the basis for an April 2023 ballot initiative approved by voters that included a 0.14% sales tax increase and the debt necessary to make the facility a reality. Community engagement over the course of several decades, including meetings, presentations, focus groups, and opportunities for input, has resulted in the final design of the new Community Recreation Center.

Barker Rinker Seacat, the lead architect, headed up the design team that included many local engineers and architects. The firm was selected after a Request for Proposals (RFP) was distributed in 2023. The group used the concept design from the 2022 CRC plan as the basis for design, incorporating the public feedback provided over the years. Following the public engagement session last fall, the design is complete and will be presented to the community on April 30, 2024.

The other important aspect of the project is the process of identifying the Construction Manager/General Contractor, which was conducted through another RFP, resulting in the selection of FCI. FCI will provide cost estimating to keep the project on budget, they will manage the groundbreaking this summer, and they will oversee approximately two years of construction. The approximate grand opening of the Grand Junction Community Recreation Center is scheduled for late 2026.

Curious to see inside the Community Recreation Center? Take a virtual tour of the facility!

Presentation from the April 30 public meeting.

Thank you to the Community Recreation Center funders: GJ residents and visitors via sales tax, the Department of Local Affairs, and St. Mary's.

2026:

The Community Recreation Center is expected to open to the public in late 2026. Memberships will go on sale June 8, 2026. Please visit the Community Recreation Center Website for more information about the facility.

2025:

The City of Grand Junction Parks and Recreation invited residents to help shape the identity of the new Community Recreation Center through an online survey and a community meeting. The survey gathered input on naming and visual style. On April 1, 2025, community members attended an interactive meeting at the Lincoln Park Barn, where they received project updates, shared feedback on branding elements, and explored ways to stay involved, including signing up for future construction tours. View a live recording of the presentation below.

A groundbreaking event for the new facility was held on Saturday, June 1, 2024, at Matchett Park.

City Council adopted the final plan in November, 2022. This became the basis for an April 2023 ballot initiative approved by voters that included a 0.14% sales tax increase and the debt necessary to make the facility a reality. Community engagement over the course of several decades, including meetings, presentations, focus groups, and opportunities for input, has resulted in the final design of the new Community Recreation Center.

Barker Rinker Seacat, the lead architect, headed up the design team that included many local engineers and architects. The firm was selected after a Request for Proposals (RFP) was distributed in 2023. The group used the concept design from the 2022 CRC plan as the basis for design, incorporating the public feedback provided over the years. Following the public engagement session last fall, the design is complete and will be presented to the community on April 30, 2024.

The other important aspect of the project is the process of identifying the Construction Manager/General Contractor, which was conducted through another RFP, resulting in the selection of FCI. FCI will provide cost estimating to keep the project on budget, they will manage the groundbreaking this summer, and they will oversee approximately two years of construction. The approximate grand opening of the Grand Junction Community Recreation Center is scheduled for late 2026.

Curious to see inside the Community Recreation Center? Take a virtual tour of the facility!

Presentation from the April 30 public meeting.

  • March 2026 Community Recreation Center Update

    Share March 2026 Community Recreation Center Update on Facebook Share March 2026 Community Recreation Center Update on Twitter Share March 2026 Community Recreation Center Update on Linkedin Email March 2026 Community Recreation Center Update link

    The Community Recreation Center is excited to welcome some of the new full-time staff members:

    Ali Little, Customer Service Supervisor

    • Ali comes to the CRC team with an extensive background in the Parks and Recreation industry. She has worked for the City of Grand Junction Parks and Recreation department in various capacities for over 20 years. Ali was also previously involved in opening the recreation center in Durango.

    Molly Bethe, Aquatics Coordinator

    • Molly joins our team with over 10 years in the aquatics industry, beginning as a lifeguard in high school. She most recently served as the Aquatics Supervisor for the City of Fruita. Molly is excited to activate the five St. Mary's Pools at the CRC!

    Liz Hays, Fitness & Adult Coordinator

    • Liz brings over a decade of group fitness experience to the CRC, including five years spent owning and running her own studio. She holds four different certifications that allow her to teach a wide range of classes. Liz is passionate about providing fitness opportunities to all members of our community.

    The City posted one additional full-time position in March: Recreation Services Representative.

    The CRC is also posting part-time and seasonal positions this month, with work beginning late summer or early fall. These positions include:

    • Manager on-Duty
    • Guest Service Representative
    • Lifeguard
    • Learn to Swim Instructor
    • Fitness Instructor
    • Climbing Wall Attendants
    • Child Watch Aide
    • Custodian
    • And More!

  • February 2026 Community Recreation Center Update

    Share February 2026 Community Recreation Center Update on Facebook Share February 2026 Community Recreation Center Update on Twitter Share February 2026 Community Recreation Center Update on Linkedin Email February 2026 Community Recreation Center Update link

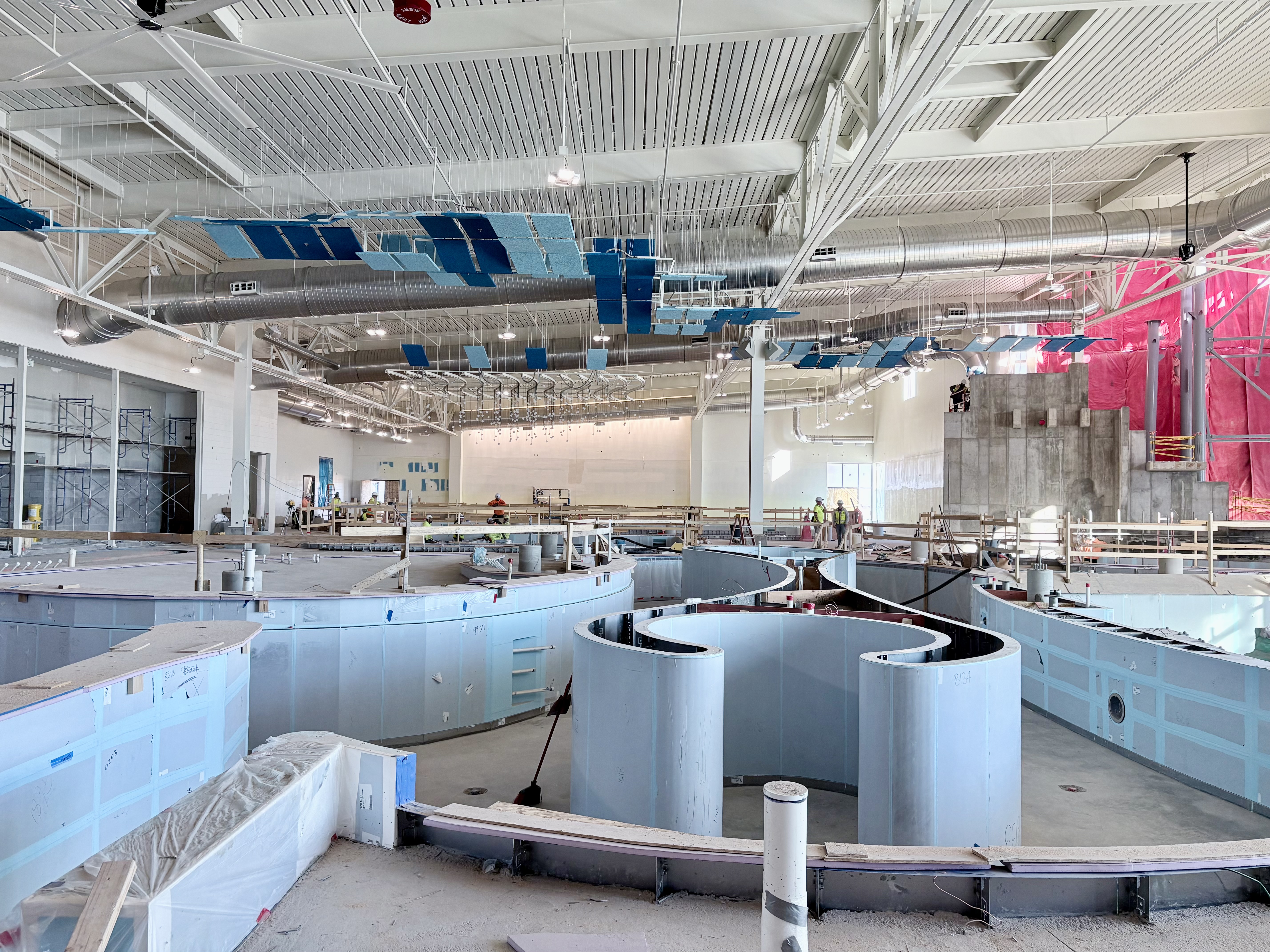

    Construction crews are working hard to continue the progression of building the Community Recreation Center. Some updates from the past month include:

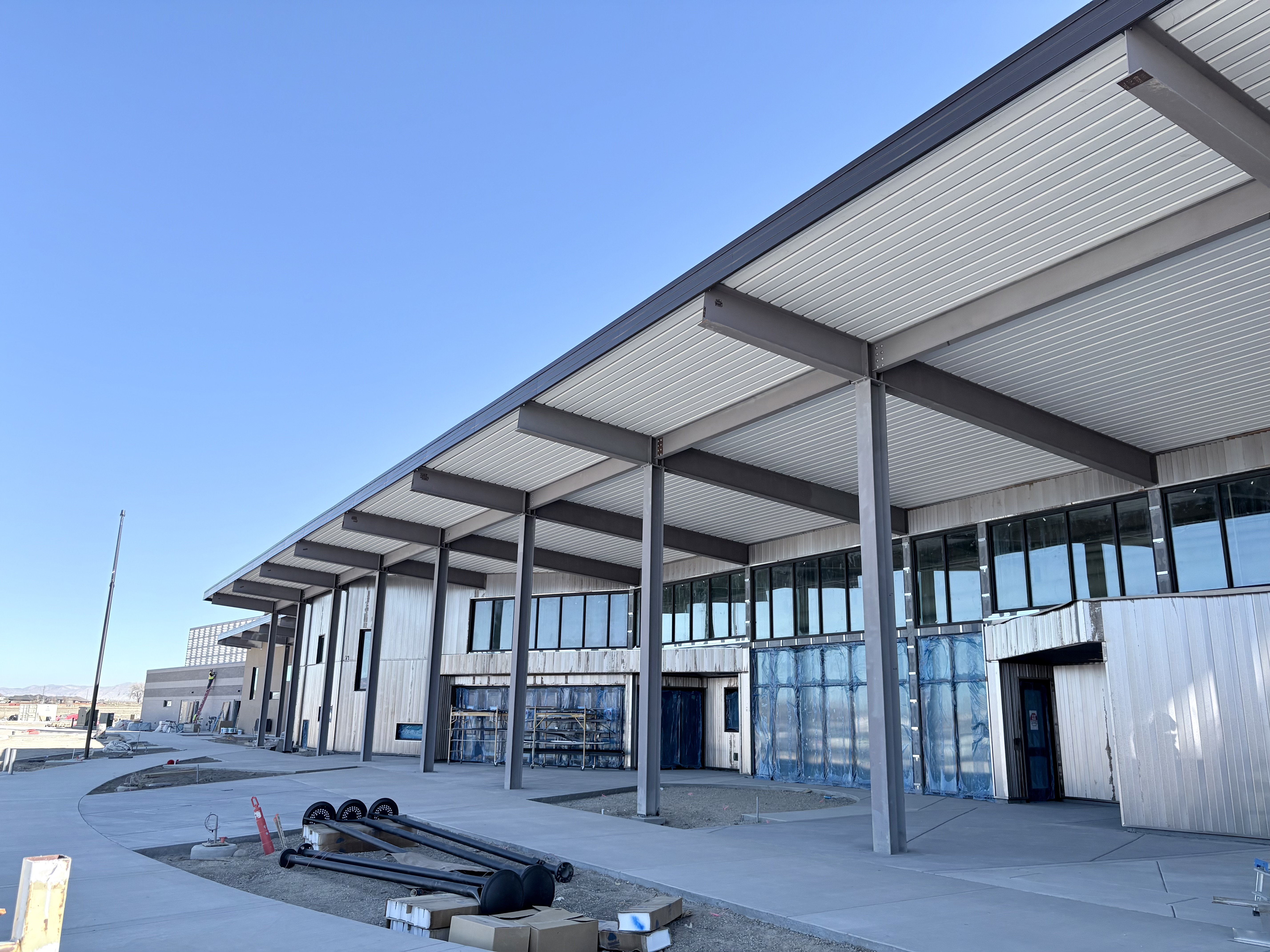

    • Exterior metal panels are being installed

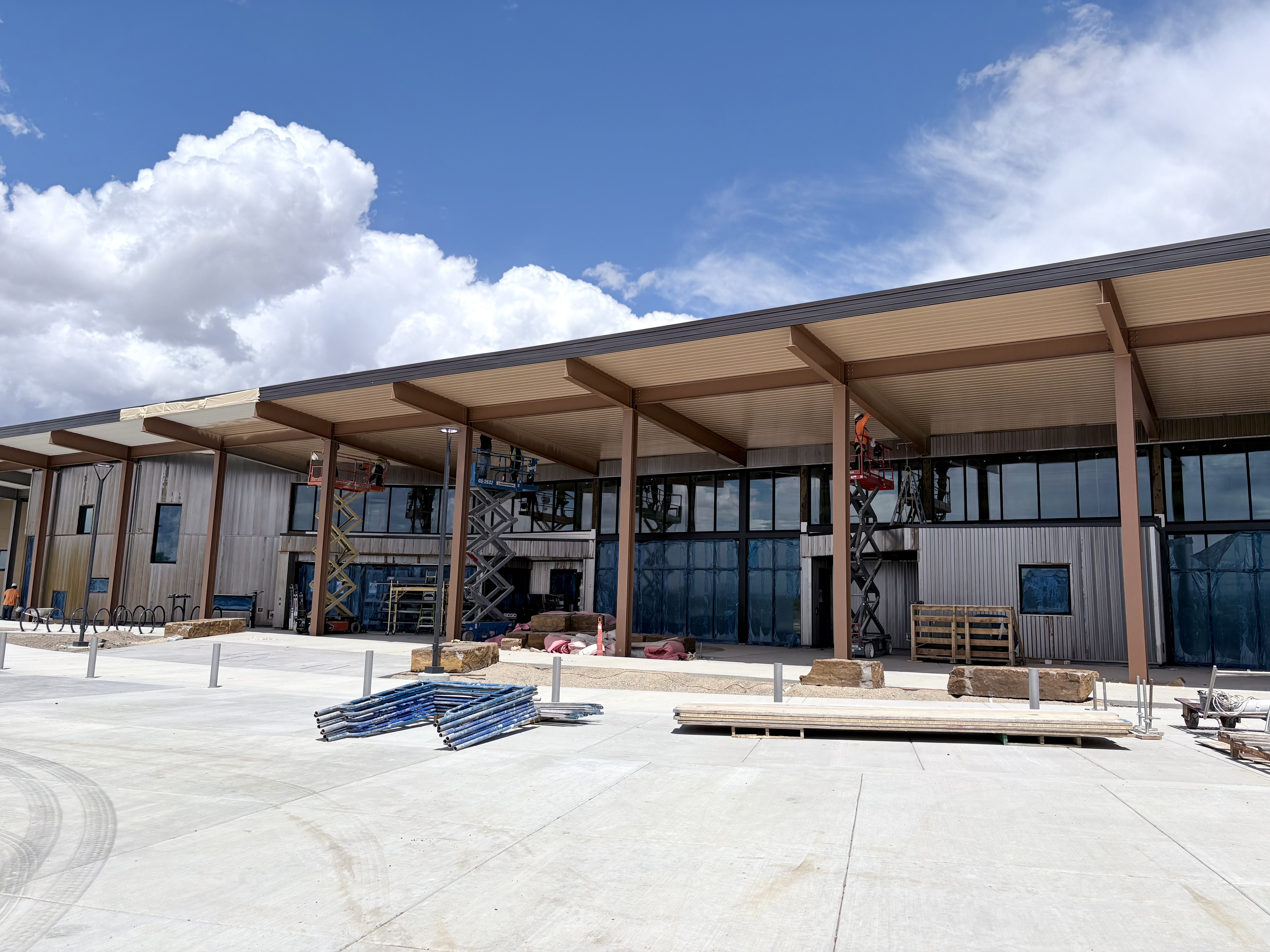

    • Cabinetry for the facility has arrived and is being installed

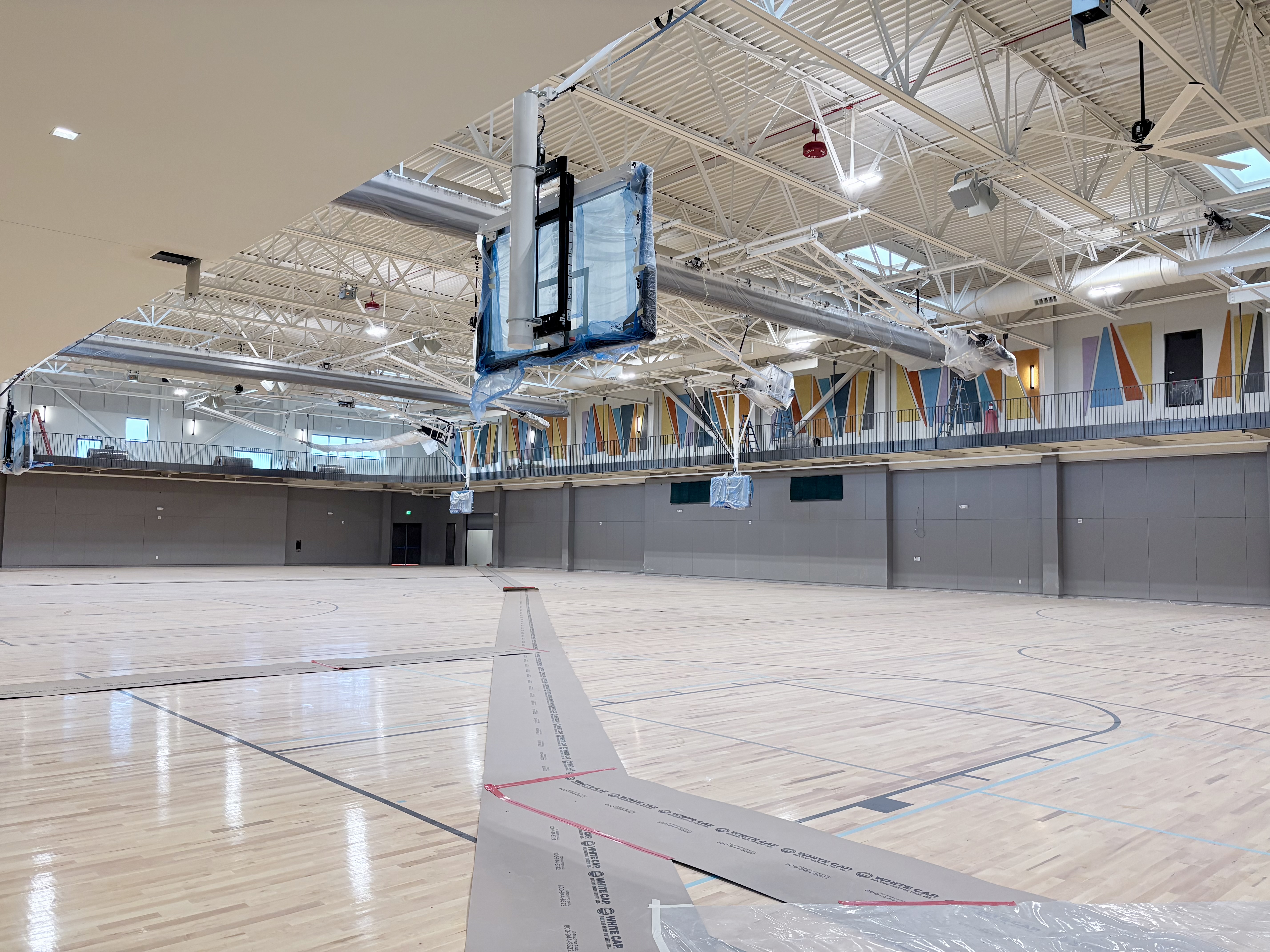

    • Gymnasium equipment is being installed
    • Dirt work on the synthetic turf multipurpose field is underway

    • Concrete work around the exterior of the facility is occurring
    • Stucco work has started on the west side of the building

  • January 2026 Community Recreation Center Update

    Share January 2026 Community Recreation Center Update on Facebook Share January 2026 Community Recreation Center Update on Twitter Share January 2026 Community Recreation Center Update on Linkedin Email January 2026 Community Recreation Center Update link

    The construction crews continue to make steady progress on the Community Recreation Center. Below are some exciting updates from the past month:

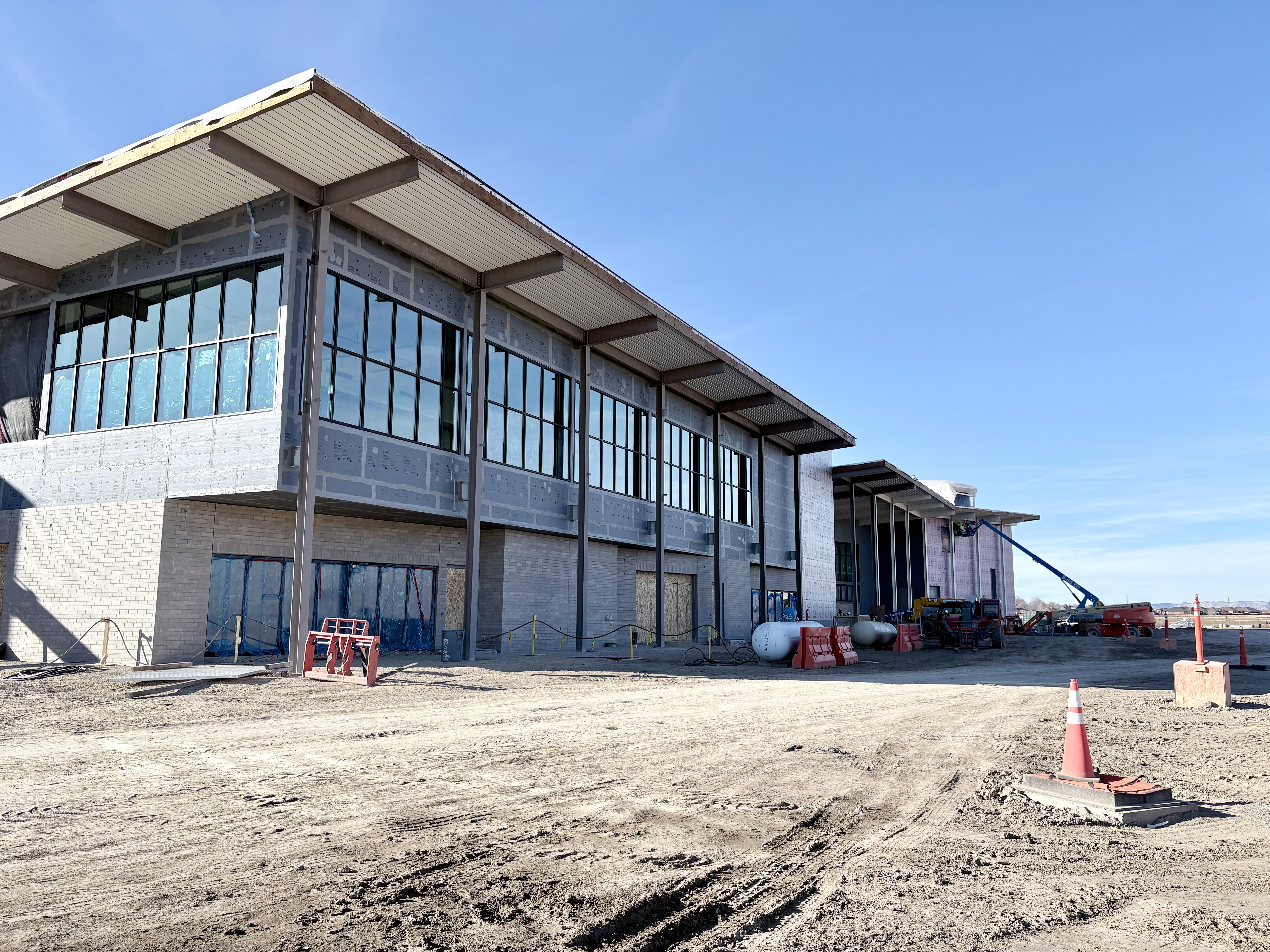

    • Exterior stucco application has begun. If you drive by the CRC on Patterson Road or 28 1/4 Road, you'll see the building's exterior color.
    • Floor tile installation is now underway in the restrooms and locker rooms.
    • Dirt work has begun for the outdoor turf field.
    • Painters are actively working on the interior walls.

  • December 2025 Community Recreation Center Update

    Share December 2025 Community Recreation Center Update on Facebook Share December 2025 Community Recreation Center Update on Twitter Share December 2025 Community Recreation Center Update on Linkedin Email December 2025 Community Recreation Center Update link

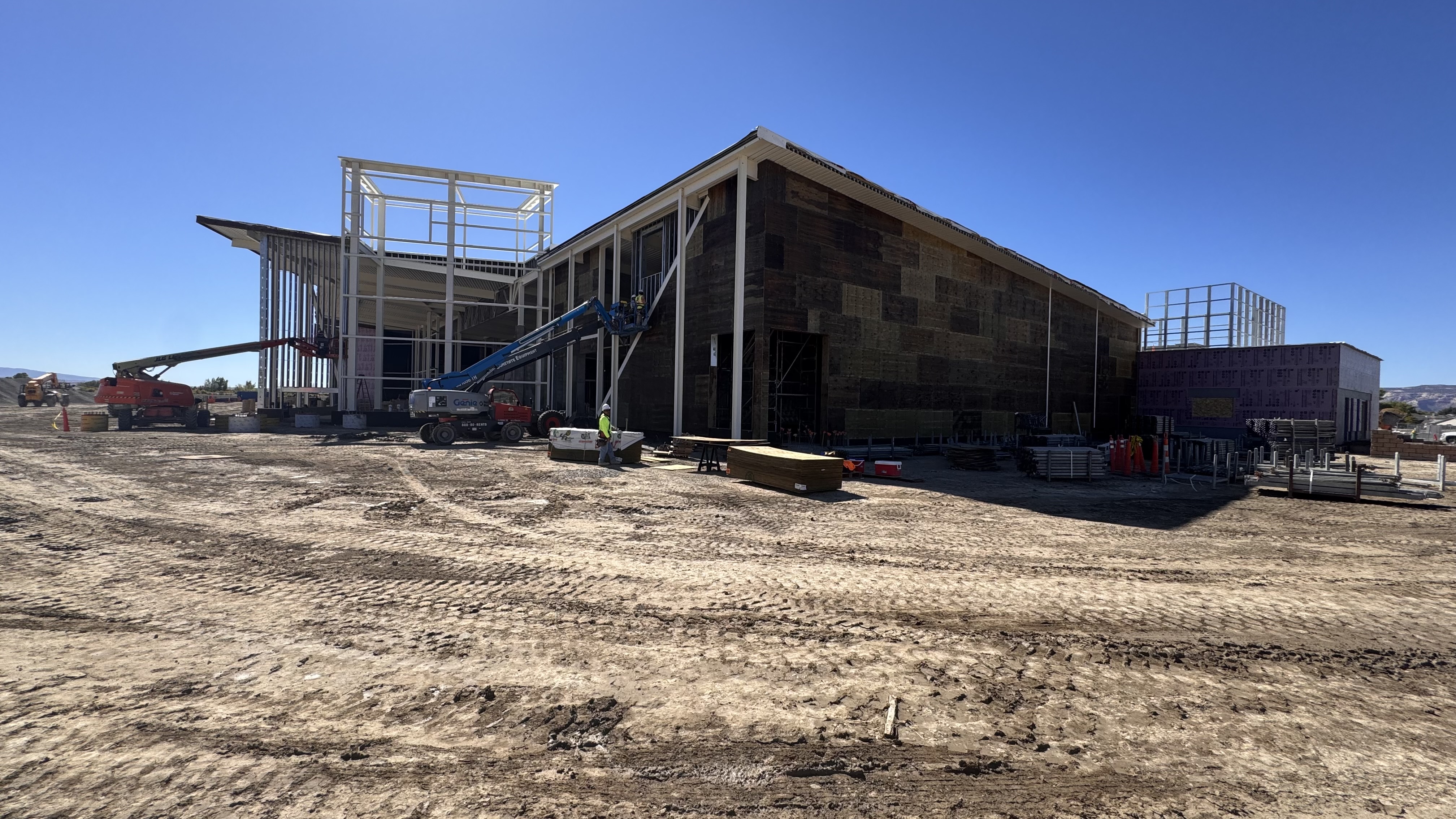

    The construction crews continue to make significant progress on the Community Recreation Center (CRC). Below are some exciting updates from the past month:

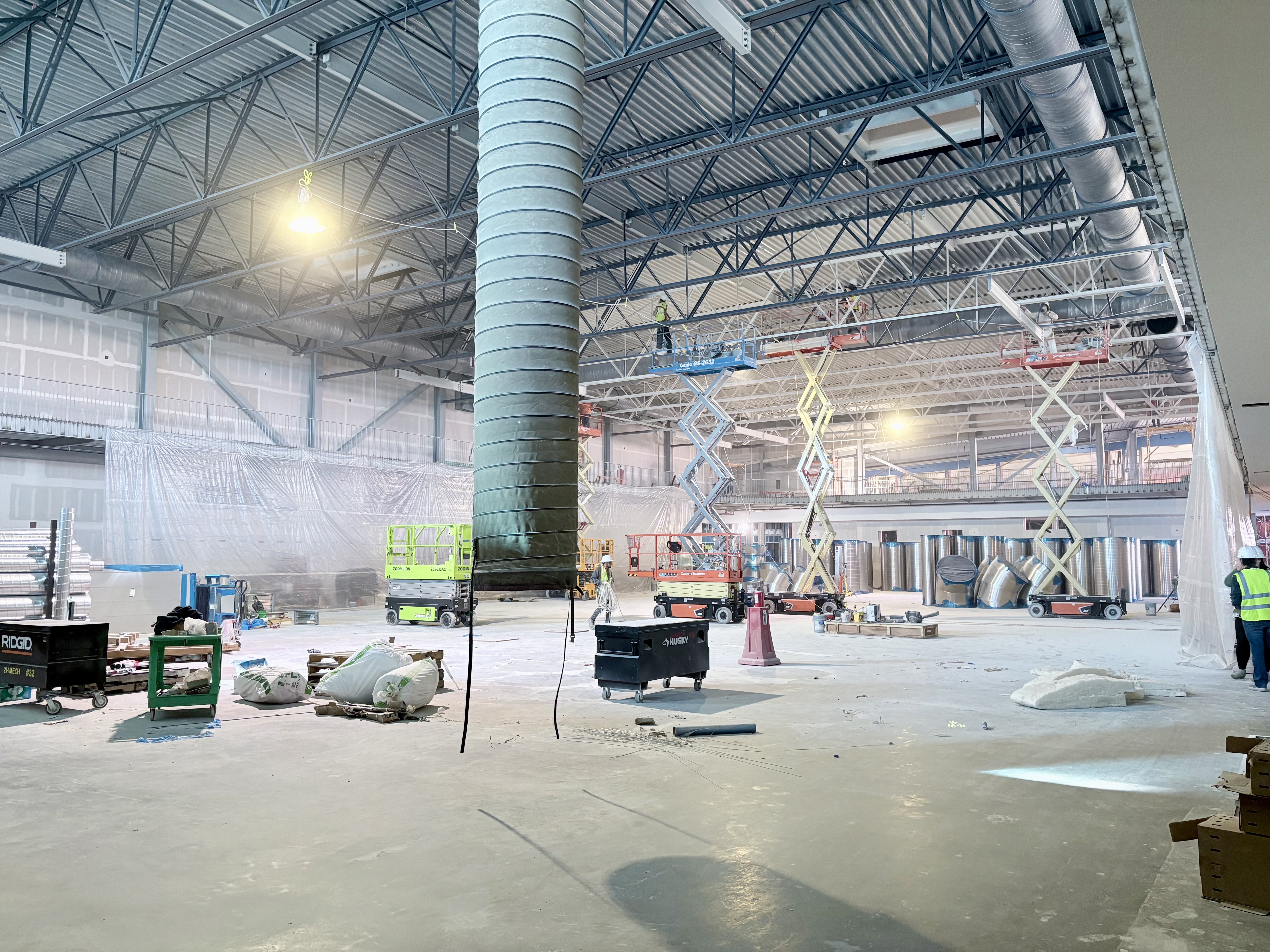

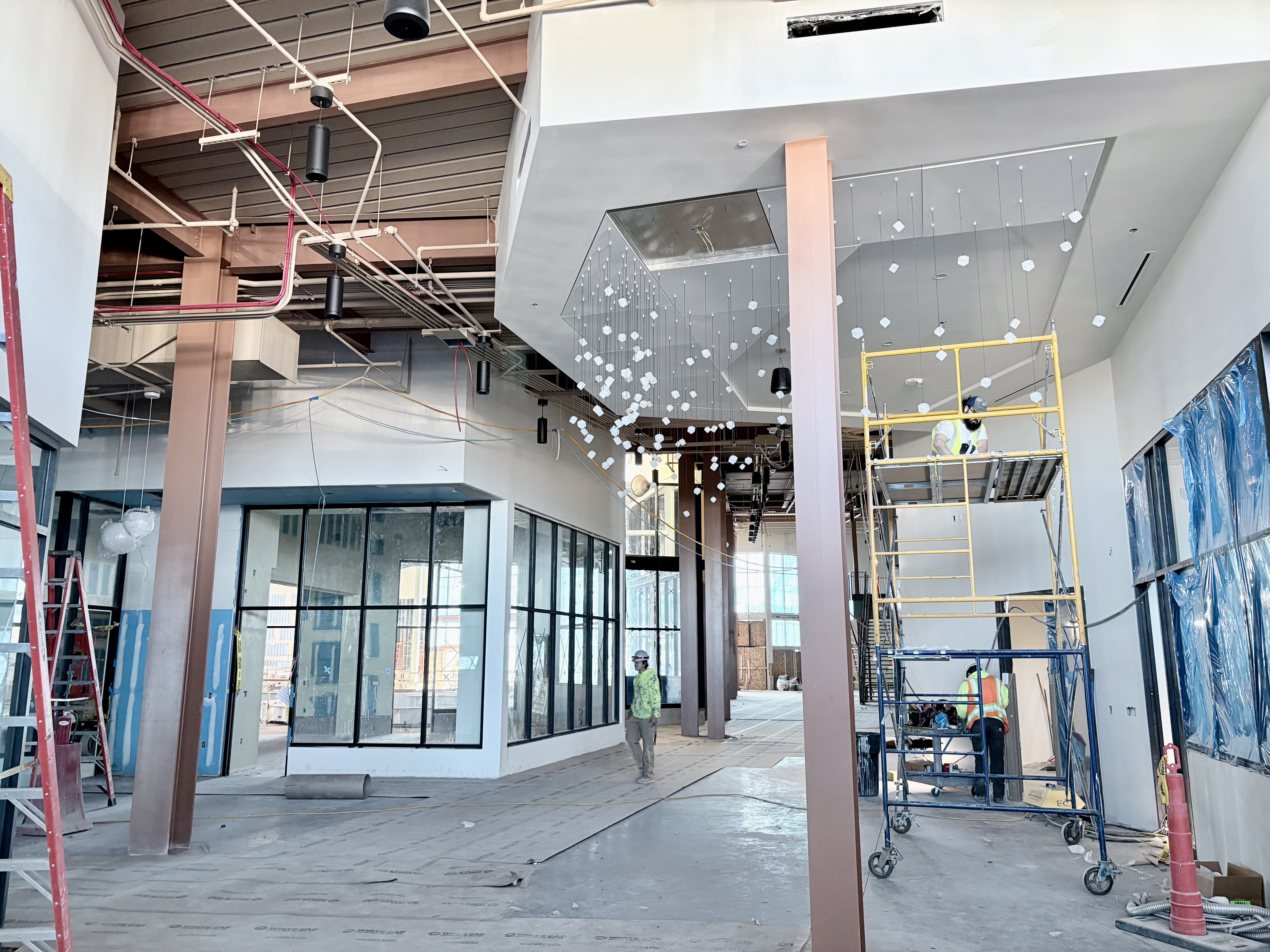

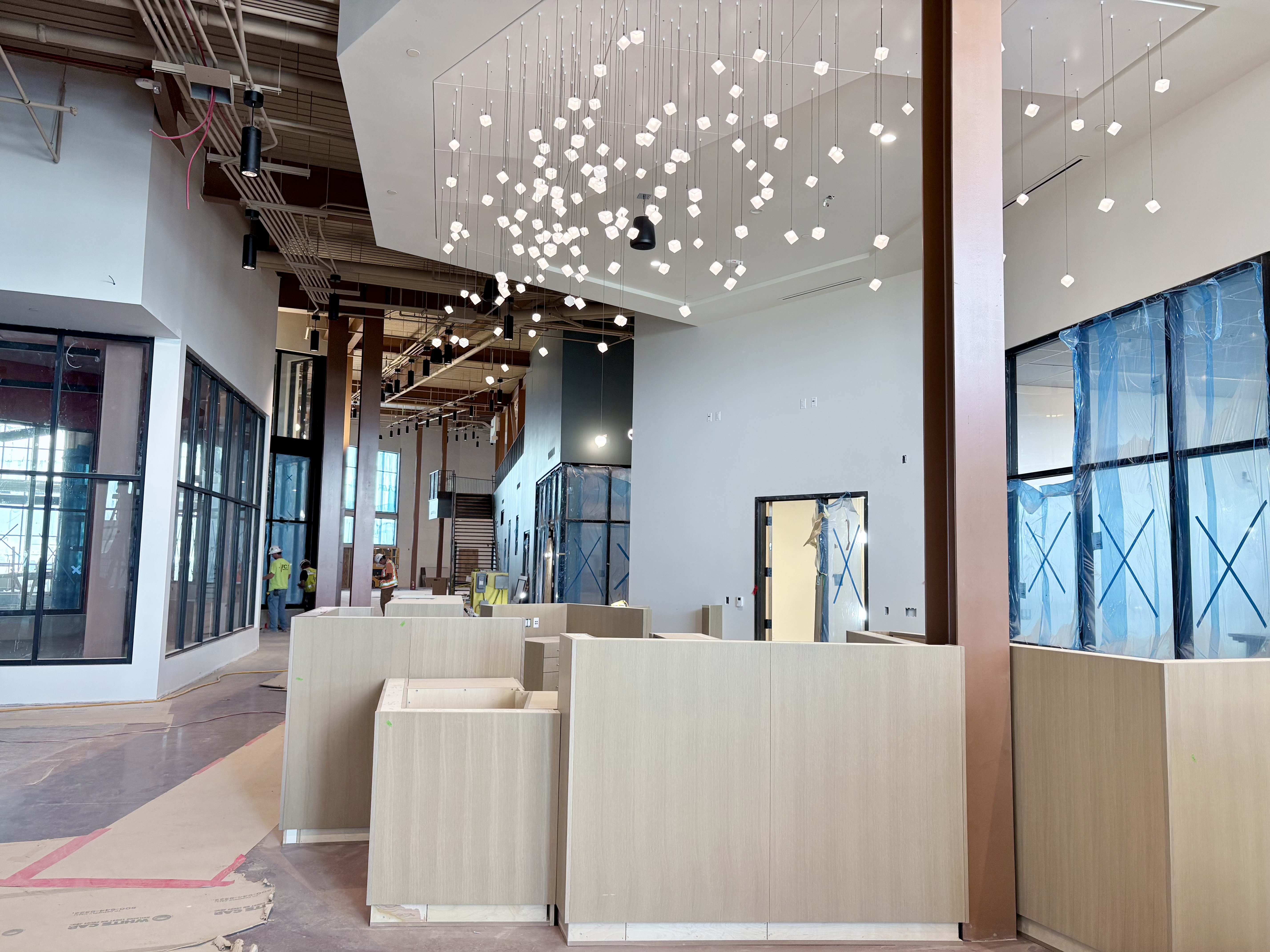

    • Interior wall framing and drywall installation are complete.
    • Painting has begun in several areas!

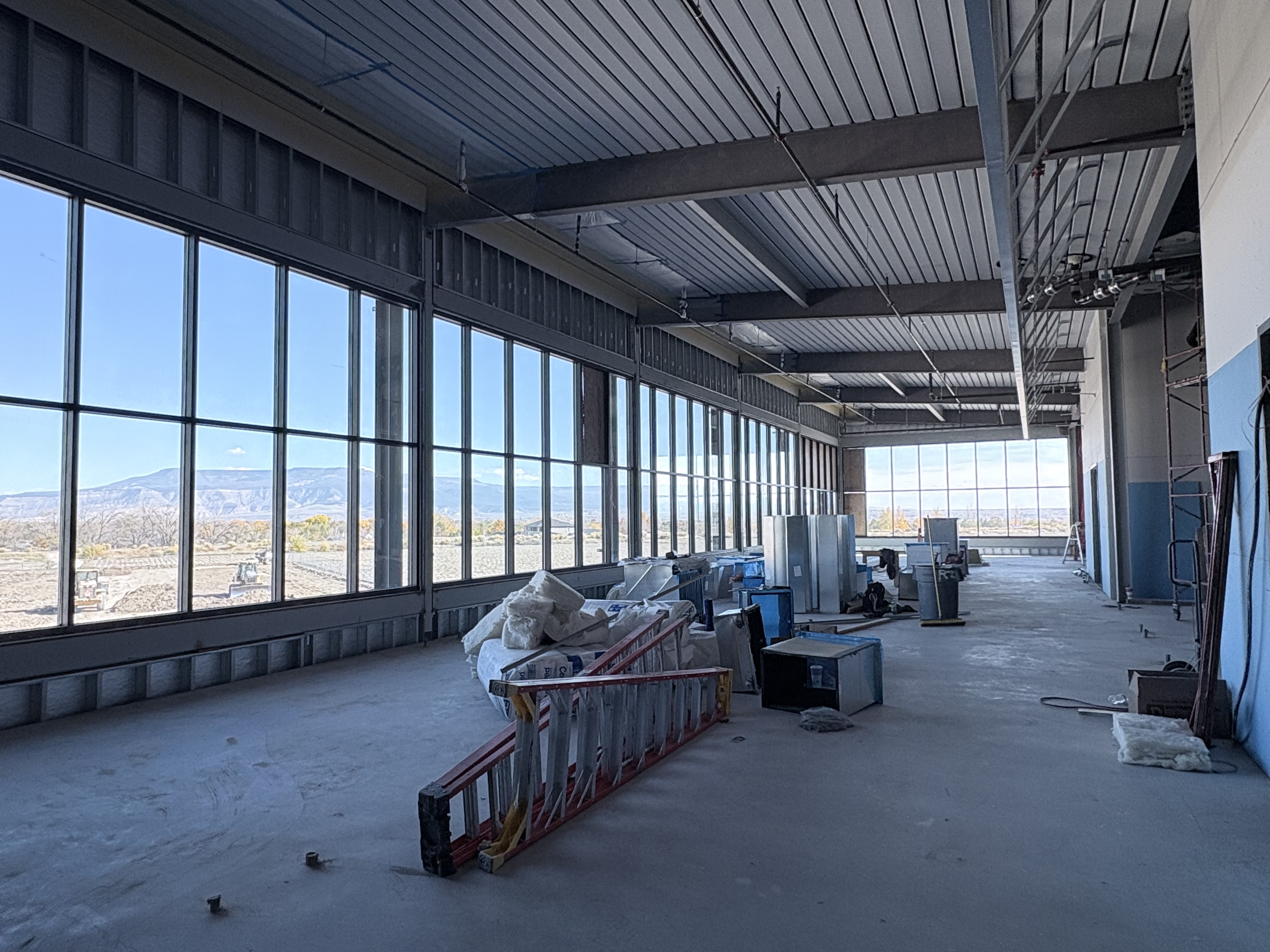

    • Installation of exterior windows is underway.

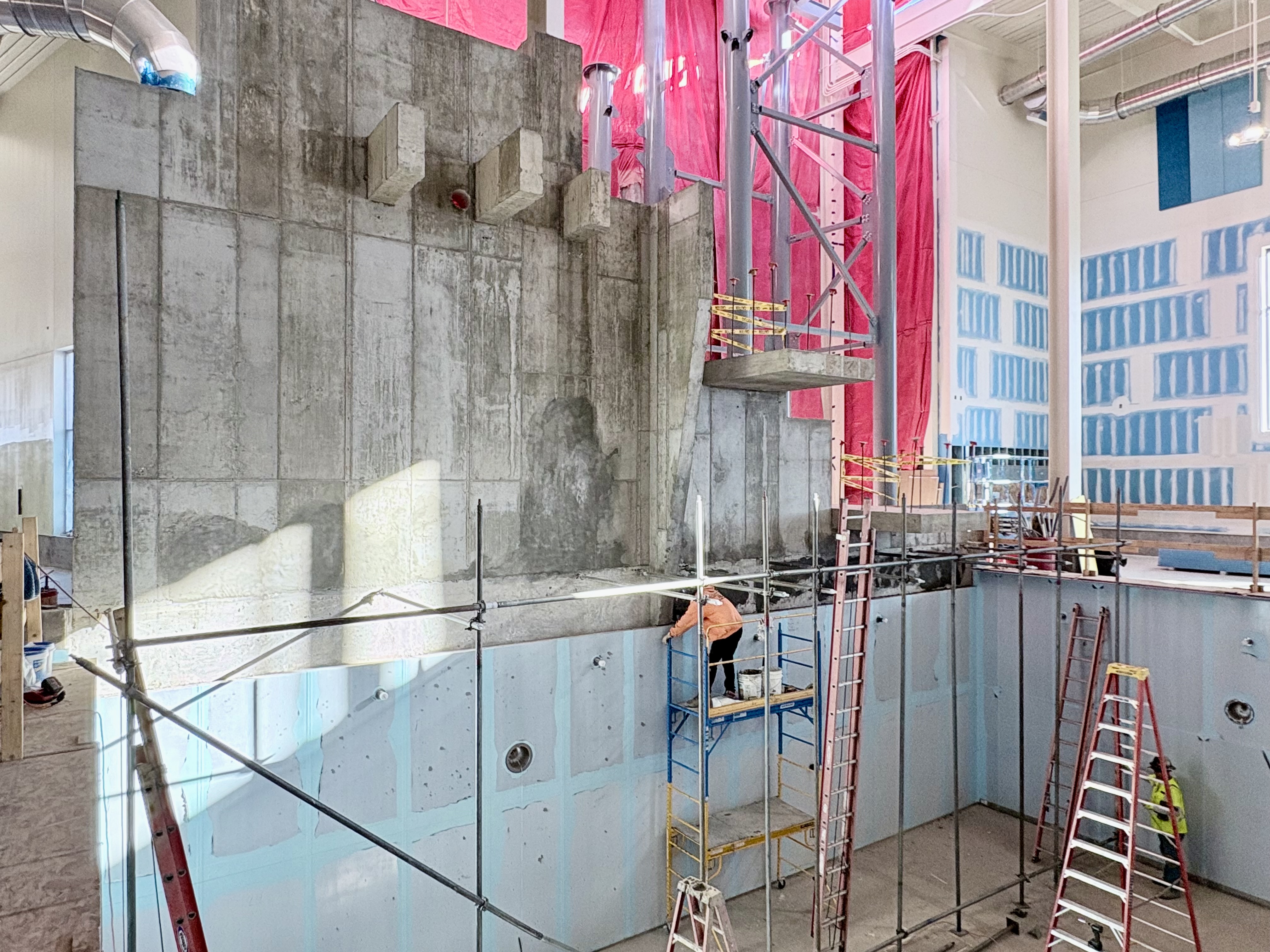

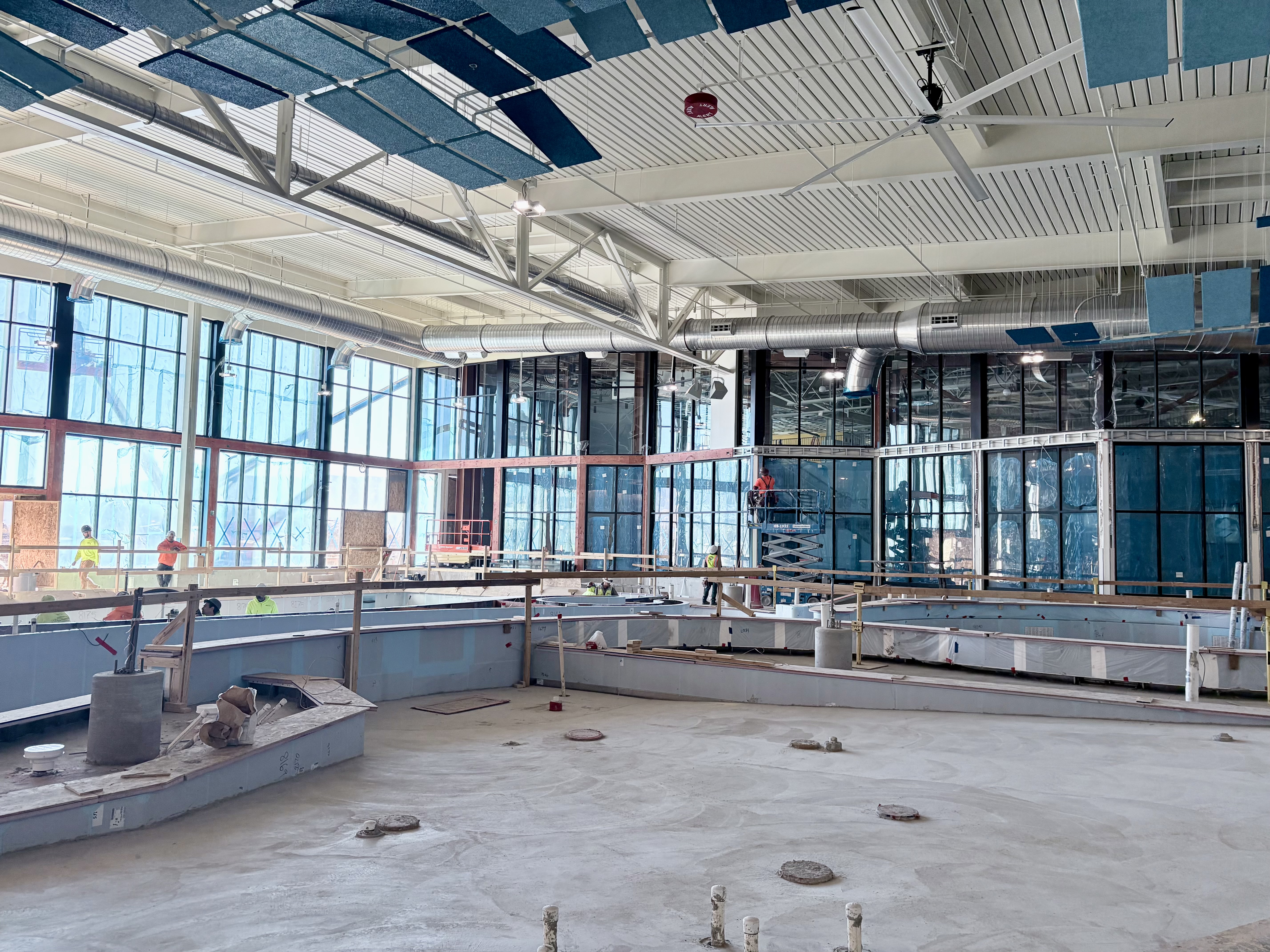

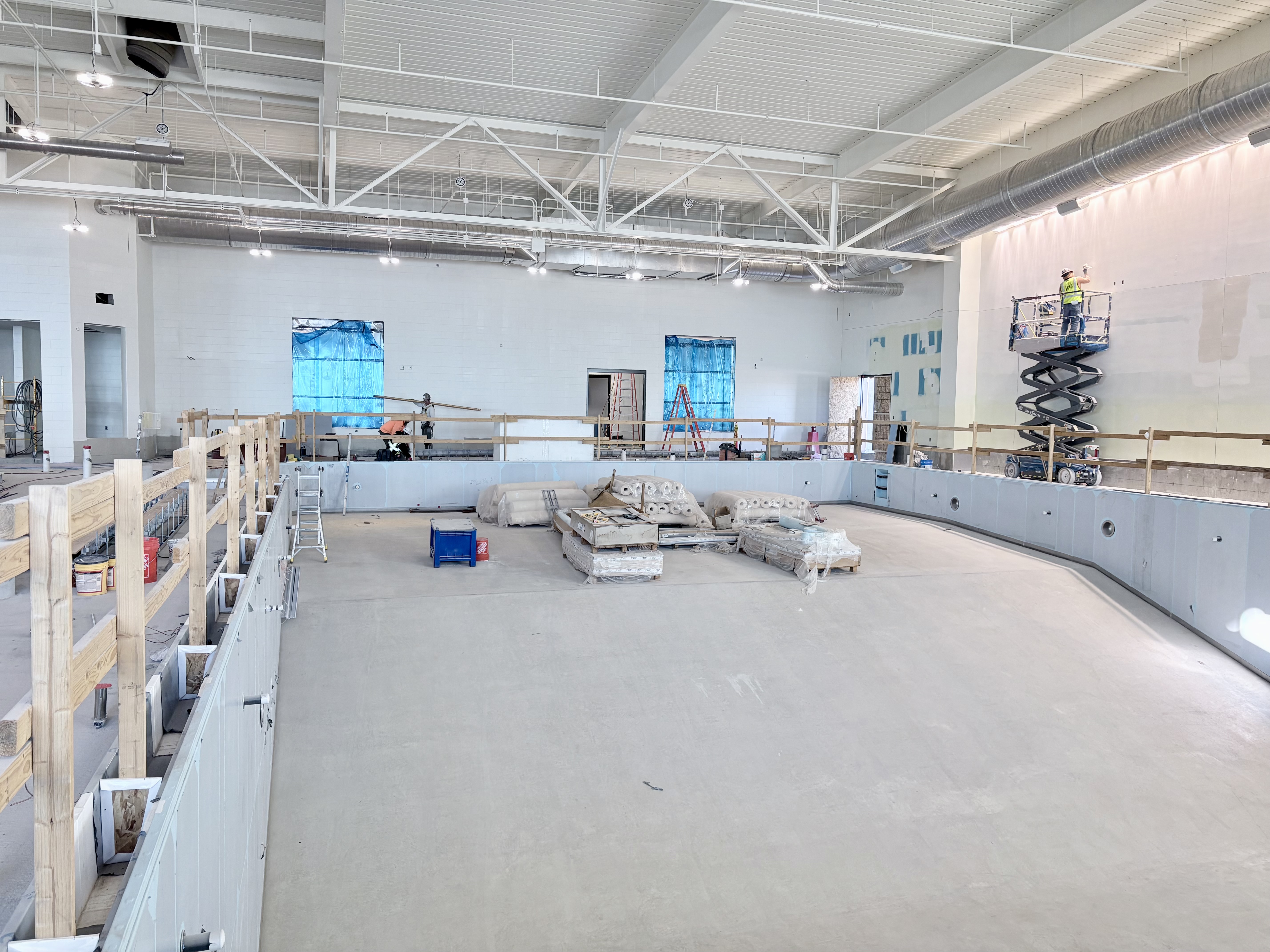

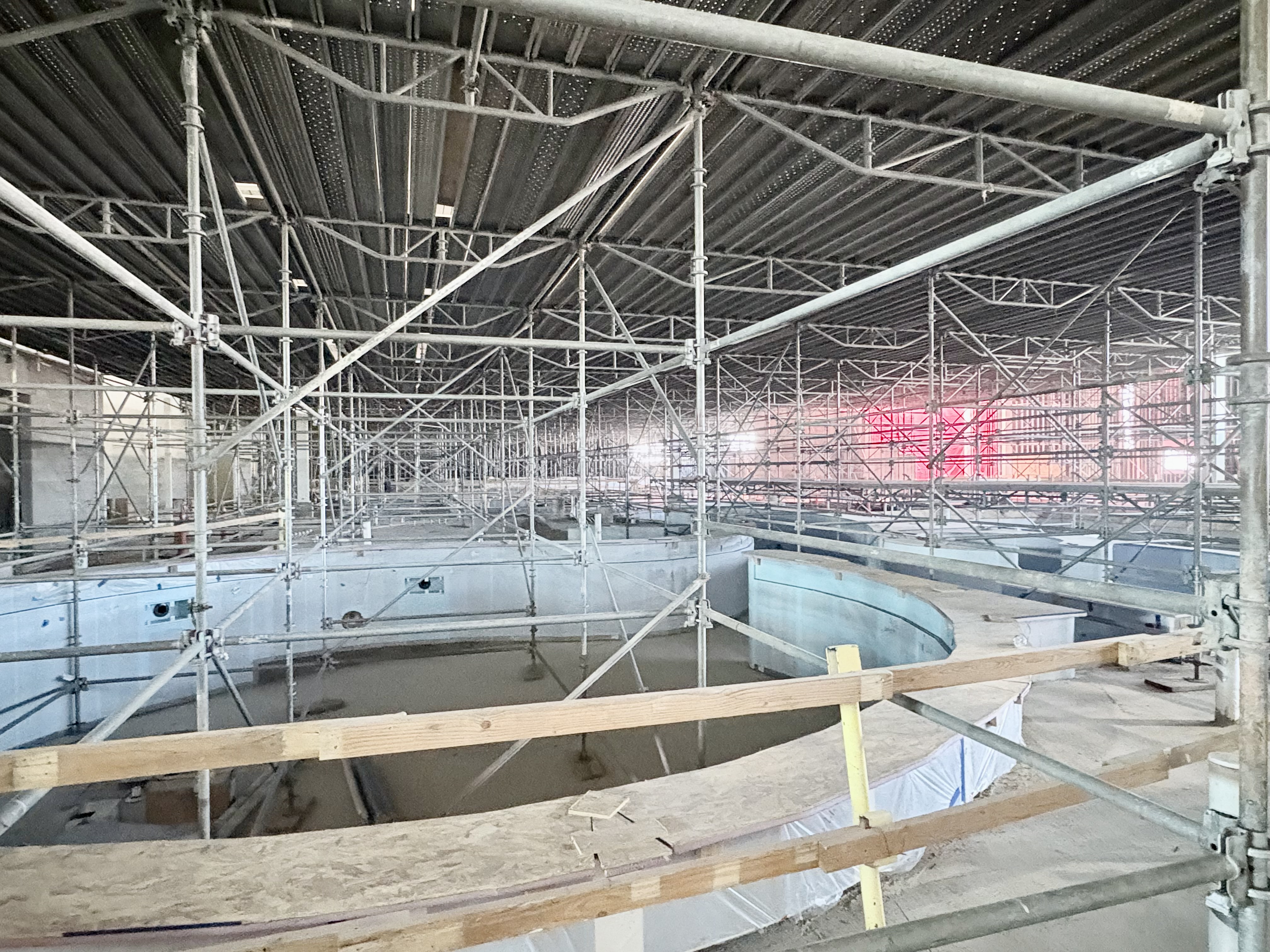

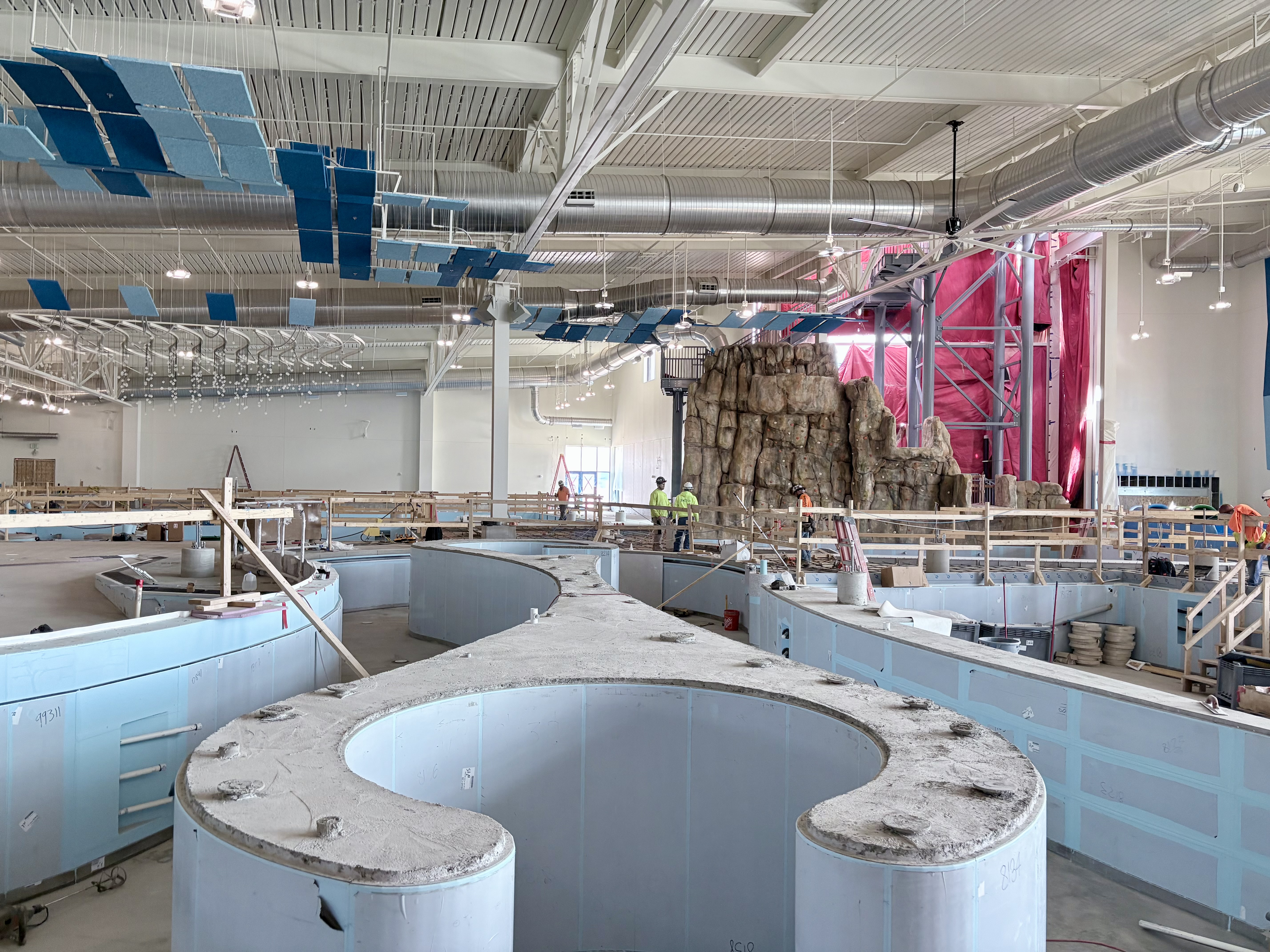

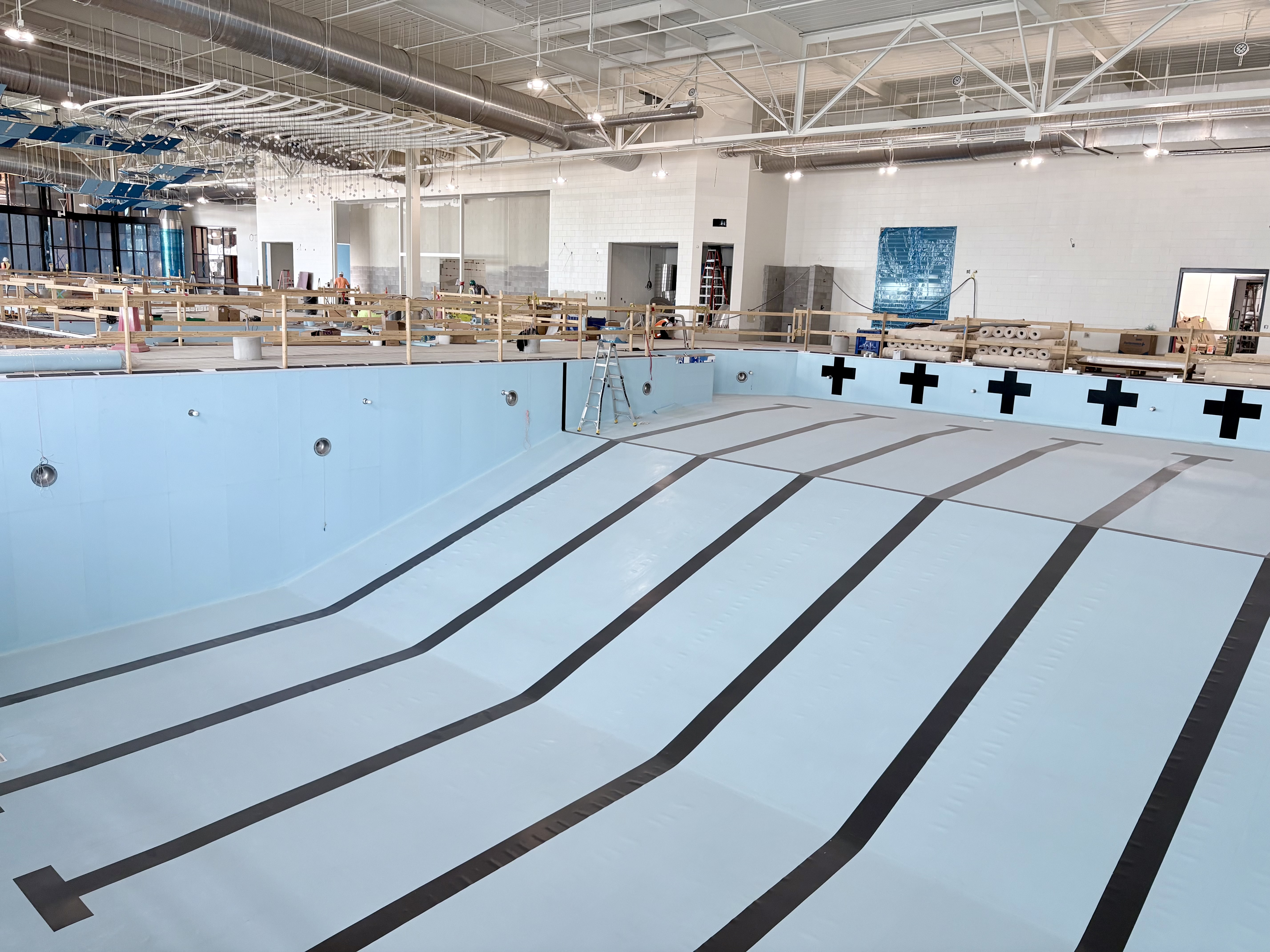

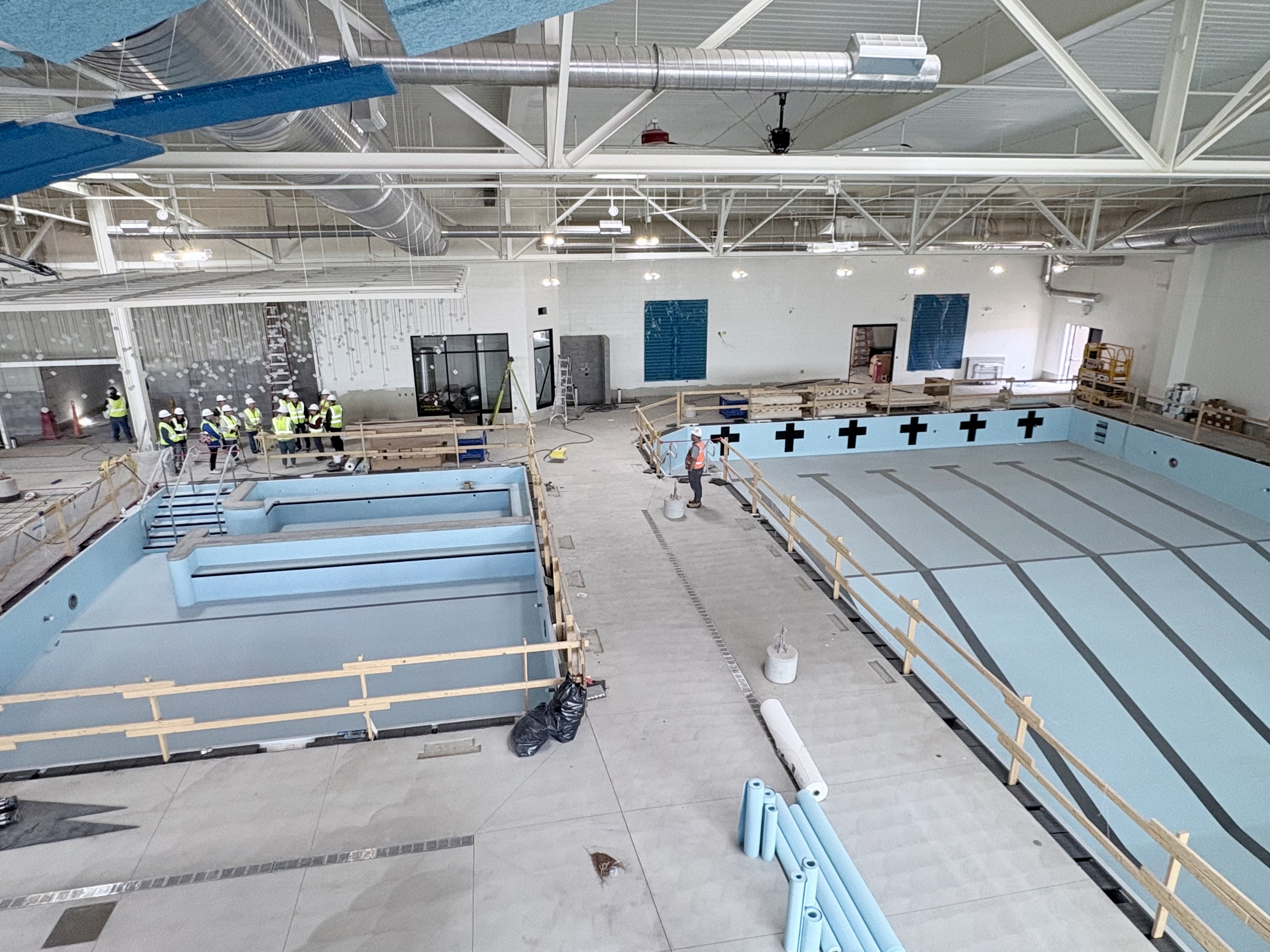

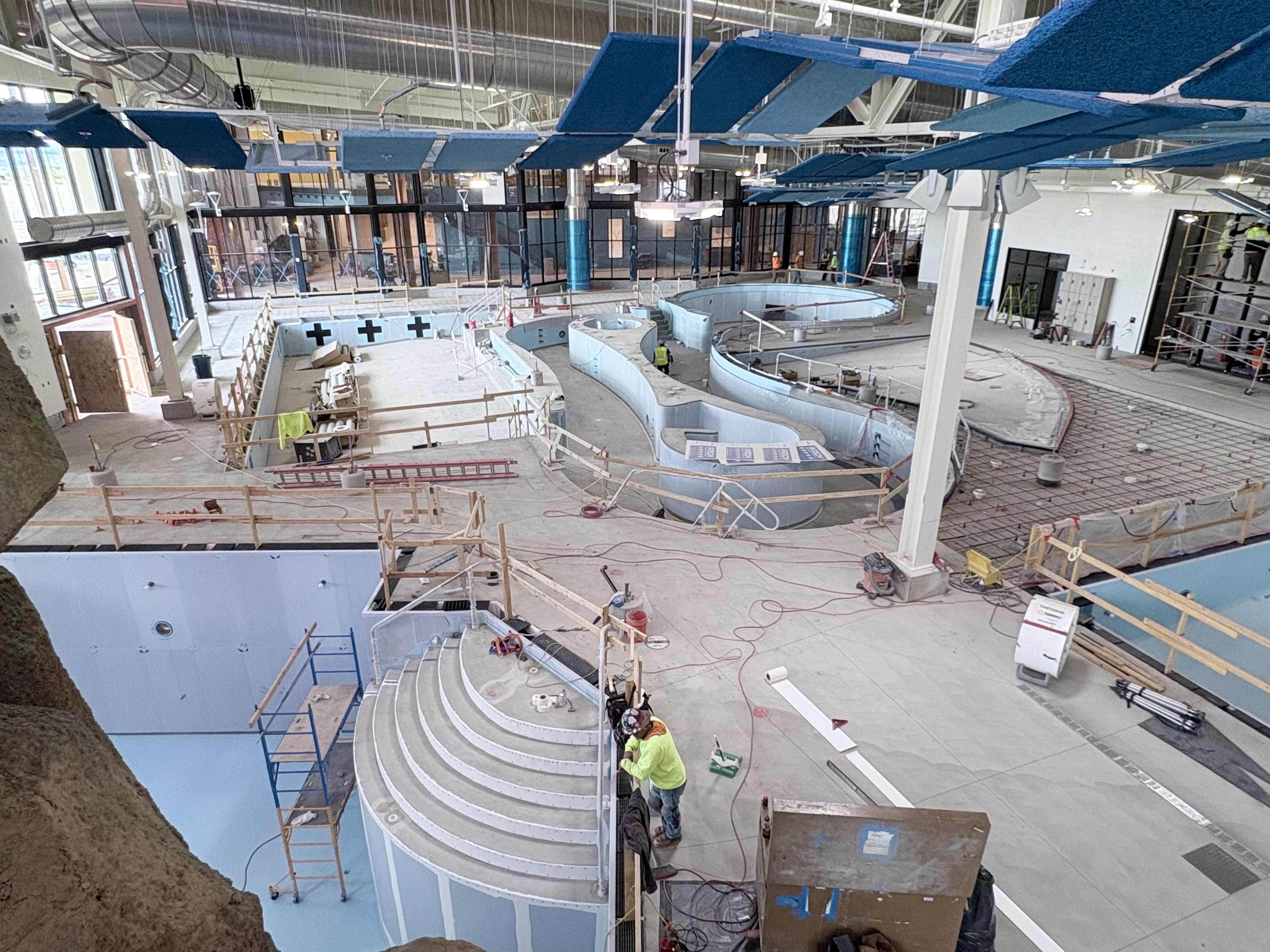

    • The pool deck beneath the slab has been poured, and each pool has been formed.

    The City's Art in Public Places program supports public art in our community by including it in select City construction and improvement projects. For the CRC, 1% of the project budget is designated to fund artwork that will be publicly visible and accessible throughout the facility. Planned art features in the CRC include:

    • Artistic lighting in the natatorium and at the front desk.
    • Acoustical sound clouds and river-themed flooring in the Kids Club.
    • A vinyl-applied graphic and tile mosaic in the natatorium.

  • November 2025 Community Recreation Center Update

    Share November 2025 Community Recreation Center Update on Facebook Share November 2025 Community Recreation Center Update on Twitter Share November 2025 Community Recreation Center Update on Linkedin Email November 2025 Community Recreation Center Update link

    The City of Grand Junction City Council has approved the addition of outdoor amenities at the Community Recreation Center (CRC), thanks to generous grantors and donors. The outdoor amenities will feature:

    • Synthetic turf field lined for soccer and lacrosse
    • Spectator seating at the synthetic turf field
    • Burkey Pavilion and event lawn space, adjacent to the CRC’s community rooms
    • Additional parking spaces
    • Synthetic fitness turf adjacent to group fitness rooms

  • October 2025 Community Recreation Center Update

    Share October 2025 Community Recreation Center Update on Facebook Share October 2025 Community Recreation Center Update on Twitter Share October 2025 Community Recreation Center Update on Linkedin Email October 2025 Community Recreation Center Update link

    CRC construction continues to progress. Major milestones in September included:

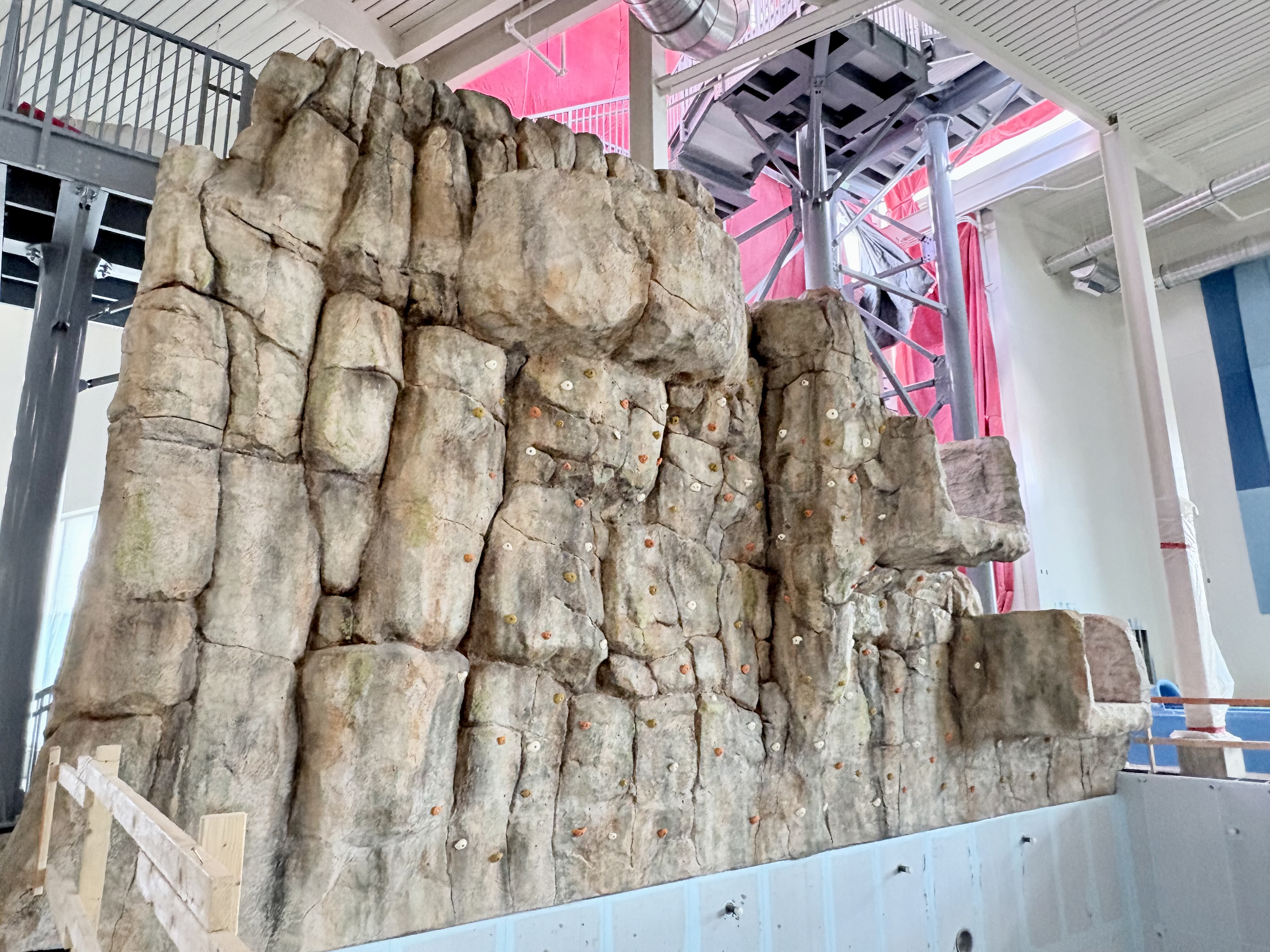

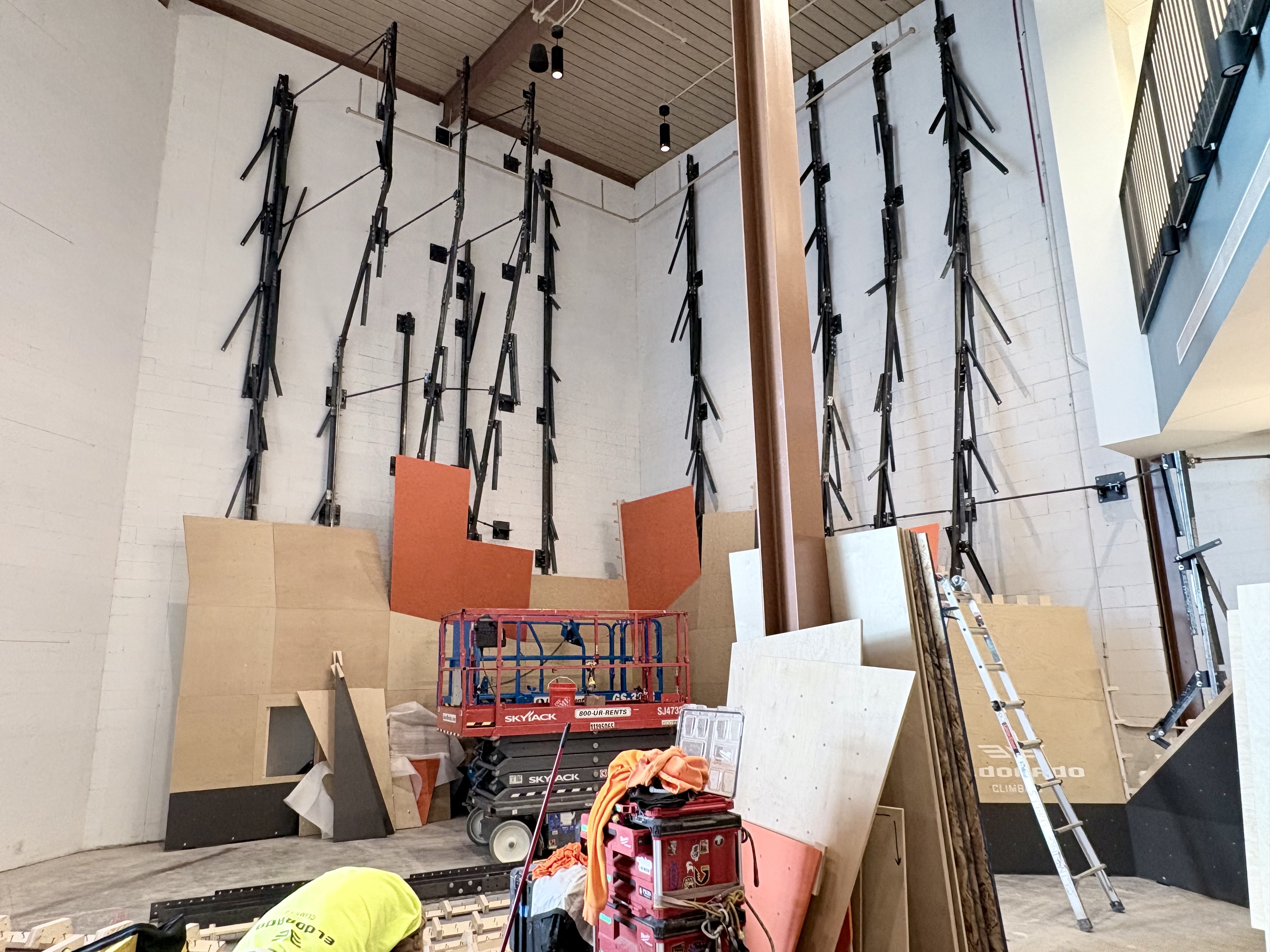

    • Eldorado Climbing was selected as the installer of the CRC’s climbing walls. There are three wall styles – Rock realistic wall designed to simulate Independence Monument, standard panelized wall, and bouldering wall.
    • The stair tower for the waterslide has begun.
    • All interior walls are framed and, in some areas, the drywall is being hung.

    Next month we will begin hiring for some fulltime positions at the CRC: Customer Service Supervisor and Aquatics Coordinator. Over the next several months, we will onboard eleven full time positions. Beginning in the spring of 2026, we will begin hiring part-time and seasonal staff. Positions include:

    • Guest Service Representative
    • Fitness Instructor
    • Lifeguard
    • Manager on Duty
    • Child Watch Attendant
    • Climbing Wall Attendant
    • Custodian
    • Recreation Leader
    • Swim Lesson Instructor

    All positions will be posted and can be applied for on the City Employment Website.

  • September 2025 Community Recreation Center Update

    Share September 2025 Community Recreation Center Update on Facebook Share September 2025 Community Recreation Center Update on Twitter Share September 2025 Community Recreation Center Update on Linkedin Email September 2025 Community Recreation Center Update link

    CRC construction continues to progress. Major milestones in September included:

    • Eldorado Climbing was selected as the installer of the CRC’s climbing walls. There are three wall styles – Rock realistic wall designed to simulate Independence Monument, standard panelized wall, and bouldering wall.
    • The stair tower for the waterslide has begun.
    • All interior walls are framed and, in some areas, the drywall is being hung.

    Next month we will begin hiring for some fulltime positions at the CRC: Customer Service Supervisor and Aquatics Coordinator. Over the next several months, we will onboard eleven full time positions. Beginning in the spring of 2026, we will begin hiring part-time and seasonal staff. Positions include:

    • Guest Service Representative
    • Fitness Instructor
    • Lifeguard
    • Manager on Duty
    • Child Watch Attendant
    • Climbing Wall Attendant
    • Custodian
    • Recreation Leader
    • Swim Lesson Instructor

    All positions will be posted and can be applied for on the City Employment Website.

  • August 2025 Community Recreation Center Update

    Share August 2025 Community Recreation Center Update on Facebook Share August 2025 Community Recreation Center Update on Twitter Share August 2025 Community Recreation Center Update on Linkedin Email August 2025 Community Recreation Center Update link

    On August 8, the final steel beam was hoisted into place at the Community Recreation Center at Matchett Park, marking a major milestone in the construction process. Covered in hundreds of signatures from community members, partners, and council, this beam is a symbol of the teamwork that brought this project to life. In order to complete the steel structure, the construction team has installed:

    • 577 drilled piers
    • Over 1.4 million pounds of steel
    • 9,268 bolts
    • 4,828 yards of concrete
    • 881,000 pounds of rebar
